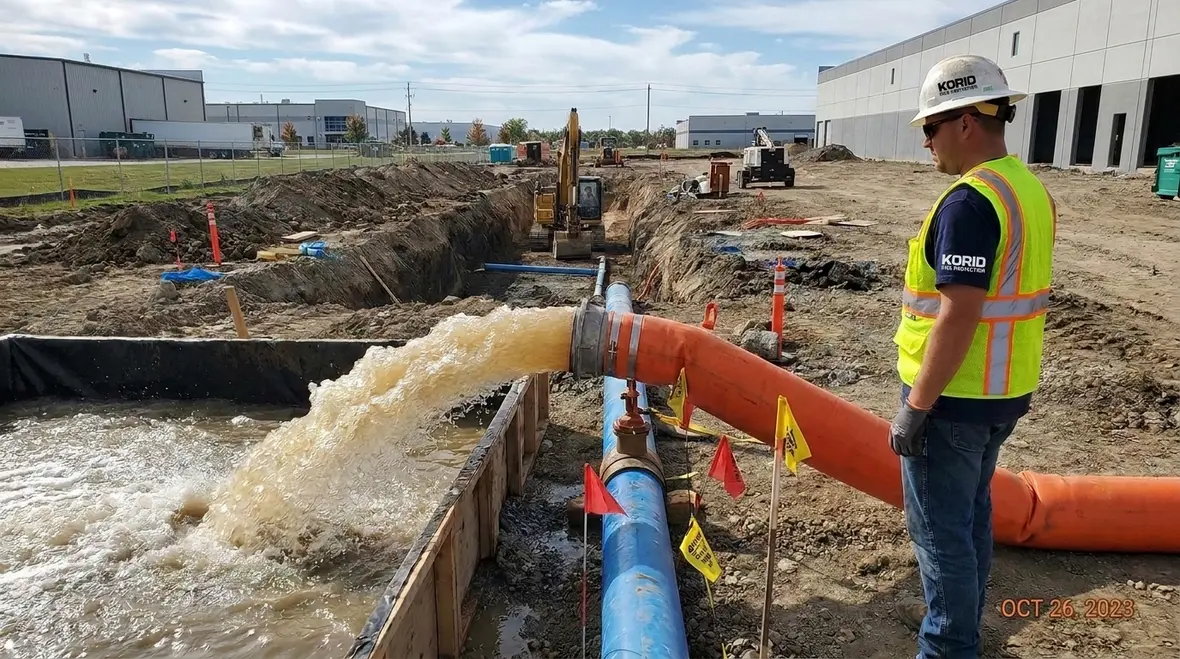

NFPA 15 Section 10.2: Why Supply Pipe Flushing at 10 ft/sec Matters Before Connection
Quick Answer
NFPA 15 Section 10.2 requires flushing the supply piping at 10 ft/sec before connections to clear debris and construction residues. This step protects water distribution performance, reduces risk of blocked nozzles and partially obstructed piping, and supports reliable system operation during inspections and fire events.
For teams planning broader fire and electrical system support for compliance, it makes sense to treat flushing as part of a complete commissioning and readiness process rather than a box to check right before handover.
Why NFPA 15 Section 10.2 flushing is a critical pre connection step
NFPA 15 10.2 flushing supply pipe 10 ft/sec underground main debris addresses a practical commissioning reality: water based fire protection systems can carry and mobilize construction waste, scale, and internal particulates. Once connected, that debris can travel to spray nozzles, valve bodies, strainers, and control components where it can cause immediate impairment or long term performance degradation.
Commercial facilities typically assume “new pipe is clean,” but underground mains and retrofit piping frequently inherit contamination from handling, threading, welding, transport, and field assembly. Flushing at the required velocity is the method that creates enough shear force and flow energy to move that material out of the system before the piping is permanently connected.
What NFPA 15 Section 10.2 means by flushing at 10 ft/sec
Section 10.2 flushing establishes a minimum flow velocity of 10 ft/sec in the supply piping prior to making system connections. The intent is not merely to “move water” but to achieve a velocity high enough to:
- Overcome adhesion of fine scale and particulates to pipe walls.
- Dislodge debris trapped at elbows, tees, transitions, and underground low points.
- Carry loosened material downstream to collection points rather than into connected components.
In practice, facilities often complete hydrostatic testing and believe the system is clean. However, hydrostatic test water can dissolve or loosen deposits that settle again after test draining. Flushing immediately prior to connection reduces the chance that those deposits migrate into the finished distribution network.
Underground mains and debris: where failure starts
Common debris sources in buried and concealed piping
Underground mains are particularly vulnerable to contamination because they are concealed, difficult to inspect internally, and exposed to jobsite variables. Typical contaminants include:
- Construction scale from welding and thermal joining.
- Threading debris from screw fittings and adapters.
- Pipe handling grit and soil infiltration during storage or installation.
- Internal corrosion products from existing runs that get tied into new sections.
How debris harms fixed water spray performance
Even small obstructions can meaningfully change spray water delivery. Debris can cause:
- Blocked or partially blocked nozzles, resulting in dry areas or uneven water application.
- Reduced flow to branch lines, impacting hydraulic calculations and design discharge density.
- Valve and strainer impairment, increasing pressure drop and delaying full flow during operation.
- Water hammer and unstable flow when debris partially migrates and then settles.
When the system fails to perform as designed, it often manifests during commissioning acceptance, annual inspections, or after partial valve operation during testing. The root cause frequently traces back to pre connection cleanliness failures, especially in the buried main where debris settles and concentrates.
How to execute a compliant flush: practical commissioning steps
NFPA 15 10.2 flushing supply pipe 10 ft/sec underground main debris is only achievable if the facility can control flow conditions and verify results. A credible flushing procedure typically includes the following operational elements.
1) Confirm the piping configuration and establish flow paths
Before flushing, technicians verify that:
- Flushing ports and test headers are available to direct discharge to a safe collection location.
- Connected components that could be damaged by debris remain isolated until flushing is complete.
- Low points, high points, and horizontal runs are included in the flow path.
2) Determine the pump and discharge conditions to reach 10 ft/sec
Velocity depends on pipe diameter and flow rate. Teams calculate target flow to reach 10 ft/sec in the actual main size and confirm flow using reliable measurements. Relying on pump nameplate flow often creates variation, especially in long underground runs with fittings and partially obstructed sections.
Where facilities struggle, the common reason is that available pump capacity does not produce the required velocity across the entire main. The fix is engineering based: adjust temporary setup, add appropriate temporary piping, or use multiple passes to meet the velocity requirement where the standard expects it.
3) Flush until discharge is visibly clean and stable
As debris mobilizes, discharge may initially appear dirty, cloudy, or contain particulate. Teams typically continue flushing until the discharge clarity stabilizes and reflects an absence of ongoing mobilization from the buried segments. This is a field reality check that complements calculated flow velocity.
4) Document conditions for compliance and future troubleshooting
For commercial acceptance and maintenance continuity, the best practice includes recording:
- Date and system section flushed.
- Measured or confirmed flow velocity and basis for verification.
- Pipe size and flushing duration.
- Discharge observations and any anomalies.
This documentation reduces uncertainty during subsequent inspections, accelerates corrective actions if performance issues appear, and supports consistent maintenance records for facilities with multiple contractors and turnover in operations staff.
What inspection and maintenance teams look for after flushing
After connections, the system enters a lifecycle where inspectors validate that the hardware and distribution are clean and functional. Flushing performance directly affects later steps.
- Strainers and check valves: Excess debris often results in frequent cleaning or premature component replacement.
- Nozzle spray pattern consistency: Obstructions can create uneven water distribution and localized under protection.
- Hydraulic performance and pressure stability: Debris can increase pressure loss, pushing system operation away from design intent.
- Annual and periodic testing outcomes: Facilities that did not flush properly commonly experience recurring issues, including complaints of abnormal discharges during inspections.
For ongoing compliance support and to reduce repeating problems, many commercial and industrial operators partner with Kord Fire Protection for commissioning assistance, inspection readiness reviews, and maintenance planning. That approach helps facilities manage both the compliance requirement and the operational risk of concealed piping systems.
Integrating flushing with overall water spray system readiness
Flushing does not exist in isolation. Proper commissioning includes system arrangement, valve operation checks, and verification that no debris is introduced during connection work. For operators evaluating how water spray fixed systems are prepared for dependable operation, Kord Fire Protection provides additional guidance aligned to water spray system performance priorities: NFPA 15 enhancing fire safety with water spray fixed systems.
In addition, facilities that want broader industry context for fire pump and water delivery readiness can reference practical resources available at firepumps.org, especially when coordinating pump selection and flow verification during commissioning activities.
Frequently Asked Questions
Conclusion and next step
NFPA 15 Section 10.2 flushing at 10 ft/sec protects the system before connections lock in the distribution network. To avoid underground main debris impairing performance, facilities should plan the flushing flow path, verify velocity, flush until discharge stability, and document the outcome for compliance records. Engage Kord Fire Protection early to coordinate commissioning, confirm readiness for fixed water spray performance, and maintain inspection confidence across the system lifecycle.
